Paper II — Q3
(a) Discuss briefly capacity planning. Explain various kinds of capacity planning. 15 marks (b) Discuss in brief various phases…
Discuss briefly capacity planning. Explain various kinds of capacity planning. 15 marks
Discuss in brief various phases of quality management. 15 marks
The time taken by two machines on various jobs in a factory is tabulated in the table below:
Calculate the loading sequence for the given jobs and machines to make the line balancing properly. 20 marks
हिंदी में प्रश्न पढ़ें
सामर्थ्य योजना की संक्षेप में विवेचना कीजिए। विभिन्न प्रकार की सामर्थ्य योजना को समझाइए। 15
गुणवत्ता प्रबंधन की विभिन्न अवस्थाओं की संक्षेप में विवेचना कीजिए। 15
एक फैक्ट्री में विभिन्न कार्यों के लिए दो मशीनों द्वारा लिया गया समय नीचे सारणी में सारणीबद्ध किया गया है:
दिए गए कार्यों और मशीनों के लिए लदान क्रम का आकलन कीजिए जिससे लाइन संतुलन ठीक हो। 20
The figure this question refers to, in words
The question paper is a scan and the diagram did not survive as text. This is the figure as read from the original page — every component, value and label — so the question can be worked from the text below.

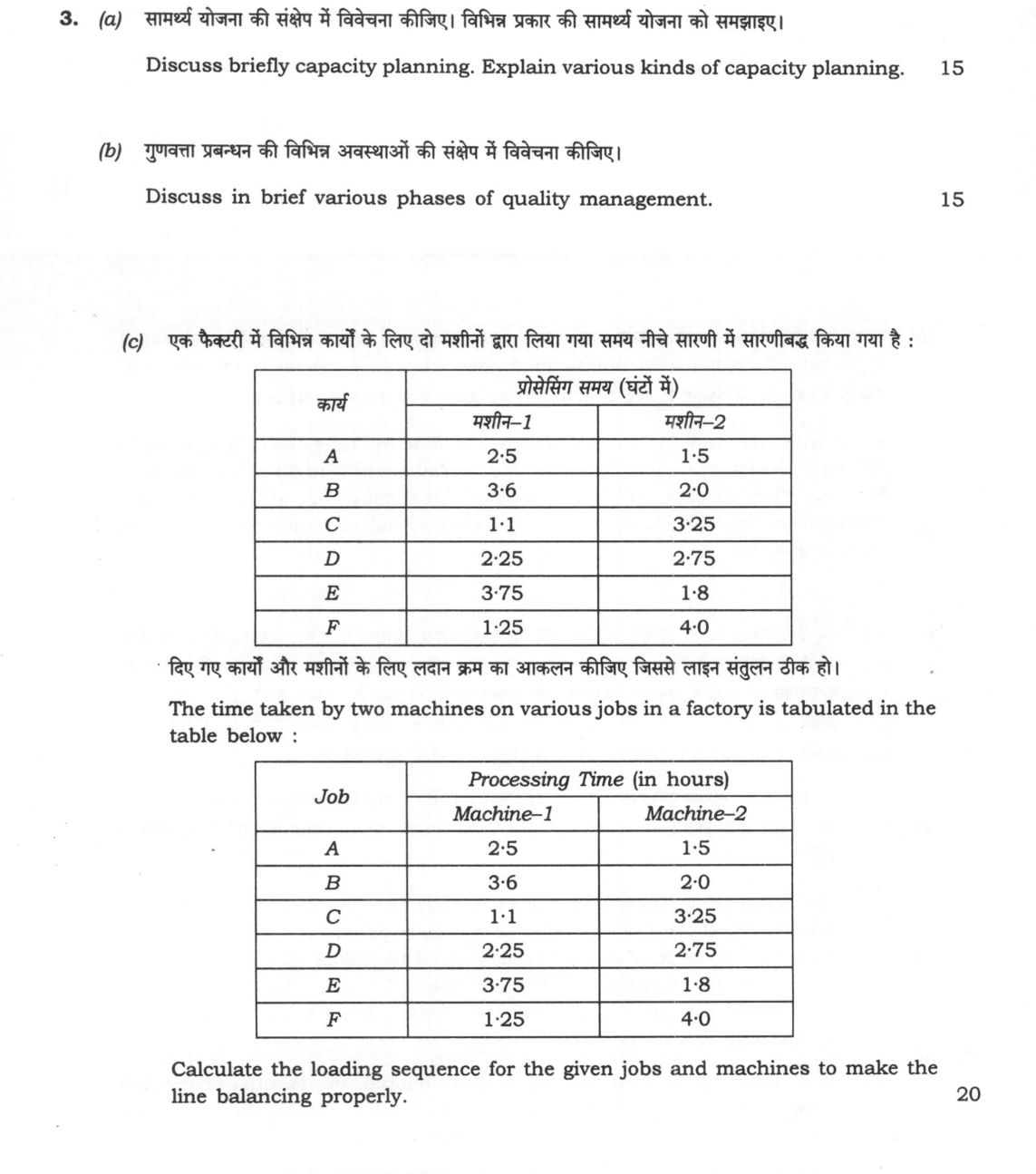

(c) Table titled 'Processing Time (in hours)'. Columns: Job, Machine-1, Machine-2. Rows: A, 2.5, 1.5; B, 3.6, 2.0; C, 1.1, 3.25; D, 2.25, 2.75; E, 3.75, 1.8; F, 1.25, 4.0.
Model answer
Drafted with AI by UPSC Answer Check against this question's marking rubric, to the expected length. UPSC does not publish answers for Mains — this is one way to score well, not an official key. How we build rubrics and answers.
(a) Capacity planning. Capacity planning is the systematic estimation of the production, service or facility capacity needed to meet forecast demand over a chosen horizon, while balancing capital cost, flexibility and service level. It links demand forecasting, product mix, technology and labour availability to plant size, shifts and equipment. It is strategic: under-capacity causes lost sales and overtime; over-capacity raises idle costs and debt. A capacity cushion — the reserve kept to absorb demand variability — is the key planning variable, its size depending on demand uncertainty, capital intensity and the cost of lost sales, and the horizon may be long-term (plant size, technology) or short-term (shifts, overtime, subcontracting). The main strategies are lead, lag and match. Lead capacity is added before demand rises, improving responsiveness but risking idle assets; lag capacity is added after demand is proven, reducing risk but limiting growth; match capacity adds small increments continuously, balancing risk and flexibility. Capacity has three levels: design capacity is the maximum theoretical output under ideal conditions; effective capacity is the realistic output after planned downtime, maintenance and quality losses; actual capacity is the output achieved. Planning uses forecasting techniques such as moving averages, exponential smoothing and regression, and project scheduling tools such as CPM/PERT for capacity expansion projects.
(b) Quality management. Quality management has evolved from inspection, where defects were detected after production, to statistical quality control, where Shewhart control charts and Deming’s statistical methods reduced variation during production. This moved into quality assurance, which builds quality into processes, suppliers and systems (design-stage prevention, ISO 9000 certification), and then into total quality management, where every function and employee is involved in customer-focused continuous improvement. Six Sigma adds disciplined DMAIC/DFSS problem solving and defect reduction. Deming’s PDCA cycle—plan, do, check, act—provides the iterative improvement loop, while Juran’s trilogy of quality planning, control and improvement gives the managerial framework; Crosby’s ‘zero defects’ and Feigenbaum’s company-wide quality complete the guru framework. In India, Tata Motors’ journey from inspection to TQM and Six Sigma, and Maruti Suzuki’s line balancing and supplier quality, show how quality systems become competitive assets.
(c) Job sequencing. For the two-machine problem, Johnson’s rule is applied. For each job, the smaller processing time is identified: if it is on Machine-1, the job is placed as early as possible; if on Machine-2, as late as possible. The minimum times are C=1.1 on M1, F=1.25 on M1, D=2.25 on M1, B=2.0 on M2, E=1.8 on M2 and A=1.5 on M2. Sorting the M1 jobs in ascending order (C, F, D) and the M2 jobs in descending order (B, E, A) gives the loading sequence on both machines: C–F–D–B–E–A. The schedule (hours) is:
- C: M1 0–1.10; M2 1.10–4.35
- F: M1 1.10–2.35; M2 4.35–8.35
- D: M1 2.35–4.60; M2 8.35–11.10
- B: M1 4.60–8.20; M2 11.10–13.10
- E: M1 8.20–11.95; M2 13.10–14.90
- A: M1 11.95–14.45; M2 14.90–16.40
The total elapsed time, or makespan, is 16.40 hours. Machine-1 works for 14.45 hours, so its idle time is 1.95 hours; Machine-2 works for 15.30 hours, so its idle time is 1.10 hours. The total idle time is 3.05 hours. The Gantt chart shows that Machine-2 is idle only for the first 1.10 hours, while C is on Machine-1, and that Machine-1 is idle for the final 1.95 hours while Machine-2 completes A. This sequence balances the line by keeping both machines loaded as continuously as possible and minimising the overall completion time.
How this answer will be evaluated
Framework: Johnson's Rule
What earns full marks: Part (c) shows correct Johnson's Rule application with final sequence; (a) and (b) are conceptually precise.
Evaluation rubric
Each sub-part is marked on its own, against the marks and word limit printed on the paper.
- (a) Discuss capacity planning and explain its kinds. 15 marks
explain— definition/context → points in order → small example → short close
Must cover
- Definition and importance: matching capacity to forecast demand; costs of under/over-capacity
- Measures: design, effective and actual capacity; utilisation and efficiency
- Kinds by horizon: long-term, medium-term (aggregate), short-term; strategies: lead, lag, match
- Capacity cushion and tools (forecasting, decision trees, break-even, CRP/RCCP)
Loses marks
- Only strategies without planning horizon
- No capacity measures
Earns more
- Economies/diseconomies of scale
- Service vs manufacturing capacity
Extra mark
- Utilisation/efficiency formula with example
- (b) Various phases of quality management. 15 marks
discuss— intro → 3-4 dimensions → example → balanced close
Must cover
- Inspection phase
- Statistical quality control (Shewhart, SPC, sampling)
- Quality assurance (prevention, ISO 9000)
- TQM and beyond (Six Sigma, continuous improvement); gurus: Deming PDCA, Juran trilogy, Crosby, Feigenbaum
Loses marks
- Listing gurus without phases
- Confusing QA with inspection
Earns more
- Indian examples
- Cost of quality
Extra mark
- Timeline of phases
- (c) Loading sequence for six jobs on two machines (Johnson's rule), with elapsed and idle times. 20 marks
calculate— given → formula → substitution → result with units → interpretation
Must cover
- Johnson's rule stated correctly
- Minimum times: C 1.1, F 1.25, D 2.25 on M1; A 1.5, E 1.8, B 2.0 on M2
- Sequence C–F–D–B–E–A
- Schedule with makespan 16.40 h; idle M1 1.95 h, M2 1.10 h
Loses marks
- Wrong placement of M2-minimum jobs
- Makespan errors
Earns more
- Gantt chart
- Tie-breaking rule mentioned
Extra mark
- Comparison with an arbitrary sequence
What "Discuss" is asking you to do
Lay the issue out from more than one side — how it arose, what is claimed for it, what is held against it, and where it now stands. UPSC attaches discuss to broad topics with several live dimensions, so coverage of the dimensions earns more than the strength of your opinion.
Structure that answers it
Set the issue up → the case as it is made → the case against → the dimension both sides leave out → where the balance now lies
Where marks are lost
Listing facts with no thread between them, or arguing one side throughout and calling it a discussion.
Practice this exact question
Write your answer and it is marked point by point against the model answer above — what you covered, what you missed, what you got wrong.
